The City of Austin and the Hill Country Conservancy are working together to develop the Violet Crown Trail system. Violet Crown Trail begins at the Barton Creek Greenbelt entrance at Zilker Park and, once complete, will extend 30 miles south into Hays County. District 8

Updates

The Zilker Trailhead project at Zilker Park and the Barton Creek Greenbelt received permit approval in January 2022. The project is anticipated to go out to bid in the summer and begin construction in the summer of 2023.

The Violet Crown Trail North construction contract, sponsored by Austin’s Public Works Urban Trails program, was approved by the Austin City Council on November 4, 2021. Work began in February and will continue through early 2023. For more information, please visit the City of Austin Public Work Urban Trails page at Violet Crown Trail | AustinTexas.gov

Barton Creek Greenbelt Trail

Background

In 2006 Hill Country Conservancy (HCC) began planning a regional trail system, originally called the Walk for a Day Trail, with the aim of creating the first regional trail system in Central Texas. The goal of the project was to provide a unique recreational experience through urban wildlands, greenbelts, parkland, public right-of-ways and water quality lands. Along its route, the trail will connect scenic natural areas to neighborhoods, shopping centers, a library, and the Lady Bird Johnson Wildflower Center. Once complete, the 30-mile trail will be the longest trail of its kind in Central Texas.

Project Description

Below are several projects planned, in progress, or completed as part of the Violet Crown Trail system implementation.

In Progress

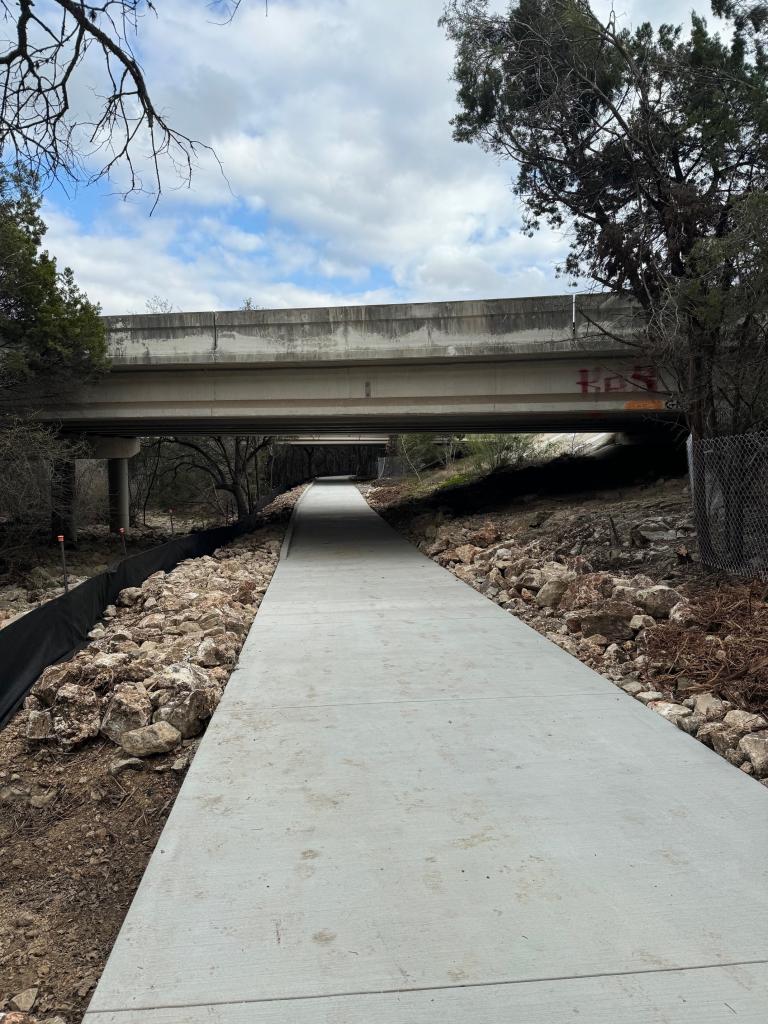

Sunset Valley to William Cannon (Violet Crown Trail North): Public Works Urban Trails program has completed the design and permitting for the trail that will connect to sidewalks on Home Depot Blvd. in Sunset Valley, travel through Sunset Valley and the City of Austin parkland to connect to sidewalks along the east side of the Mopac access road north of the William Cannon intersection. Work began in February and will continue through early 2023. More information can be found on the Urban Trails webpage: Violet Crown Trail | AustinTexas.gov

Circle C to Wildflower Center: The Parks and Recreation Department (PARD) is partnering with HCC to construct the trail that will connect existing nature trails on the west side of Mopac in the Circle C Metropolitan Park and the Violet Crown Trail connection and crossing on Slaughter Creek east of Mopac completed in 2019. Work is anticipated to begin in the spring of 2023 to be complete in late winter of 2023.

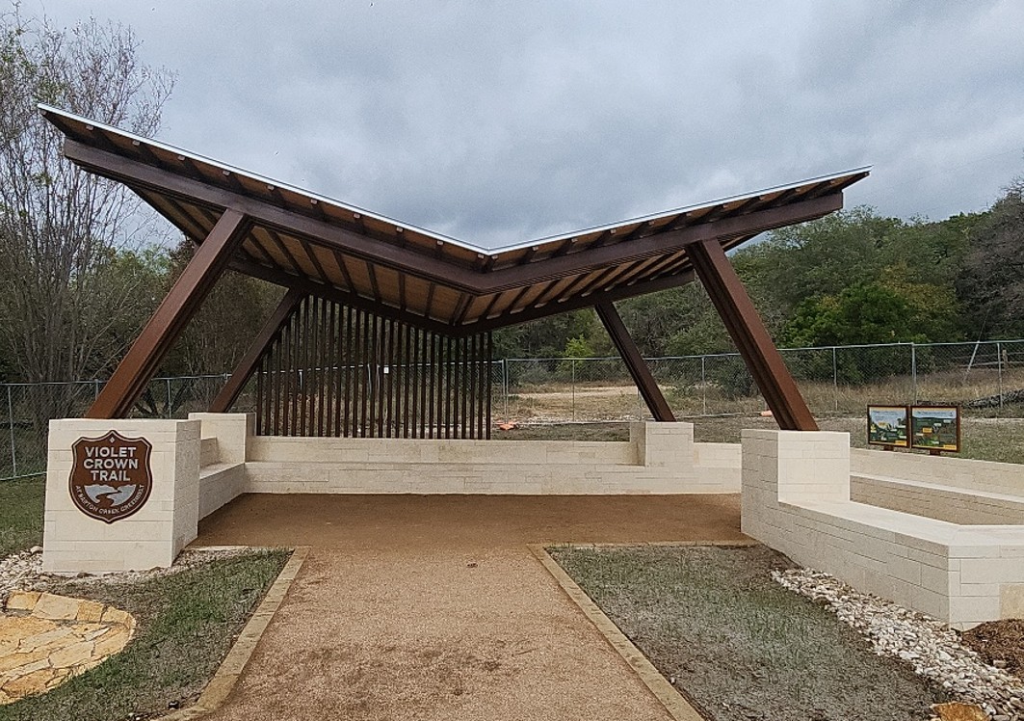

Zilker Trailhead: Through a Parkland Improvement Agreement, HCC is leading the design, permitting, and construction of a new trailhead for the Violet Crown Trail in Zilker Park and Barton Creek Greenbelt. The project received its permit in January 2022. Construction is anticipated to begin in the summer of 2023. Funding is being provided through Hill Country Conservancy, Austin Parks Foundation, and City of Austin Parkland Dedication funds.

Community engagement for the Zilker Trailhead began in the fall of 2017 and ended in November 2018. Please review the information below:

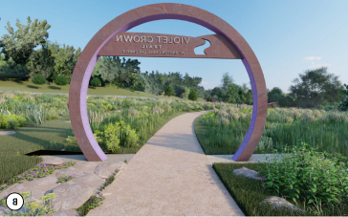

Mile 0 at the Zilker Park Trailhead for Violet Crown Trail



Complete

Barton Creek Greenbelt

Work included a 6-mile extension of the existing greenbelt nature trail in the Barton Creek Greenbelt to connect to a new trailhead in Sunset Valley at the Hwy 290 entrance. HCC designed and installed the trail mile markers and wayfinding signs through an Austin Parks Foundation grant. Work was completed in August 2015.

Barton Creek Greenbelt

Sendera Mesa Trail Connection

Through the Public Works Neighborhood Partnering Program, HCC received a grant for an urban trail connection from Davis Lane to sidewalks along Sendera Mesa Drive which then lead to W. Slaughter Lane sidewalks. Work completed in 2016.

Convict Hill to Dick Nichols Park

This section of the trail includes a new parking lot and trailhead under Mopac through an interlocal agreement with the Texas Department of Transportation. The trail is 12’ wide with a stabilized decomposed granite surface. Work completed August 2018.

Dick Nichols Park

This trail connection continues the Public Works trail through Dick Nichols Park to Davis Lane. PARD built the north portion, and HCC built the south portion connecting to Davis Lane (see map below). Portions of the trail are stabilized decomposed granite and portions are concrete to address water flow and potential erosion. HCC designed, funded, and installed the trail signage and map kiosks. Work completed in 2019.

Dick Nichols Park

Slaughter Creek Connection

HCC continued the trail connection from Slaughter Lane to Slaughter Creek in the Slaughter Creek Greenbelt. Work included two low-water bridge crossings. Work completed in 2019.

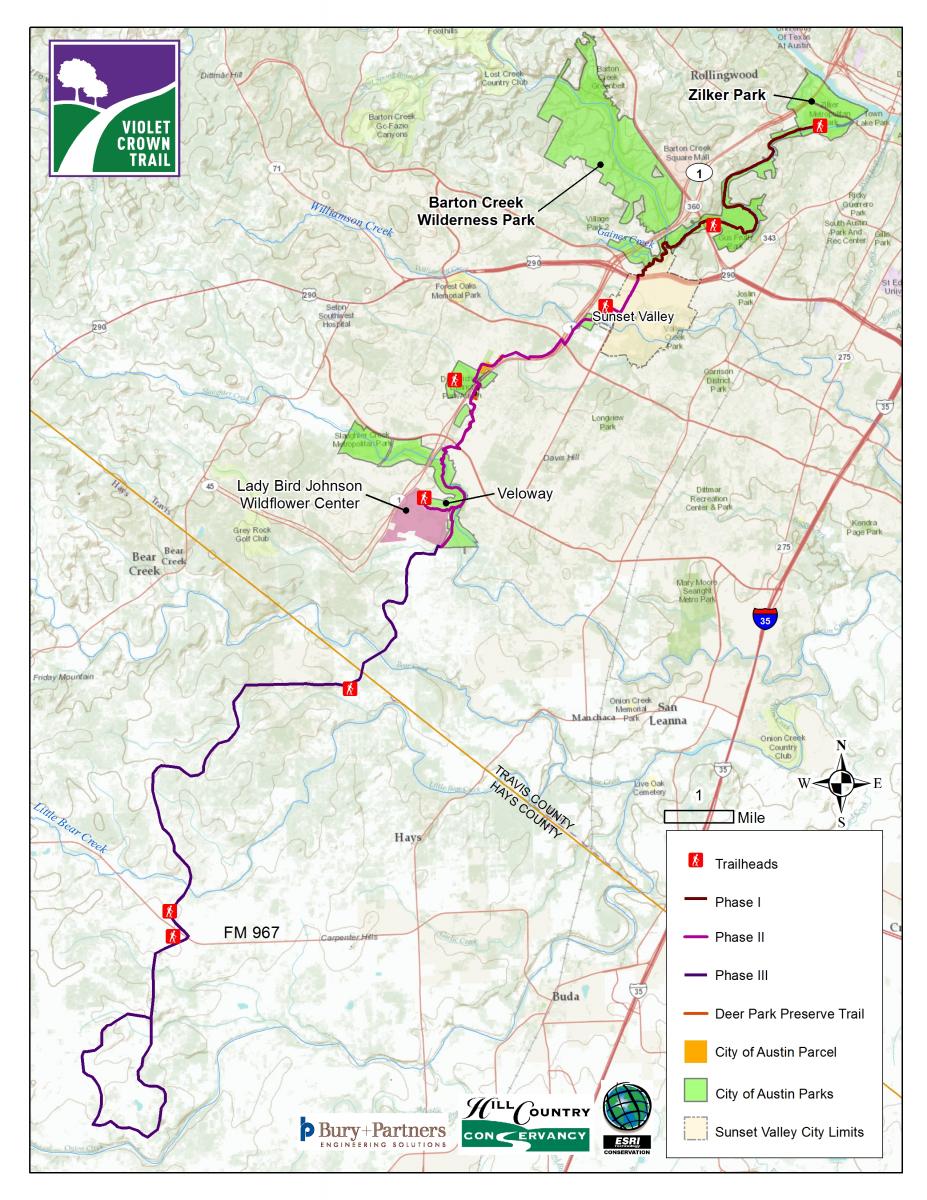

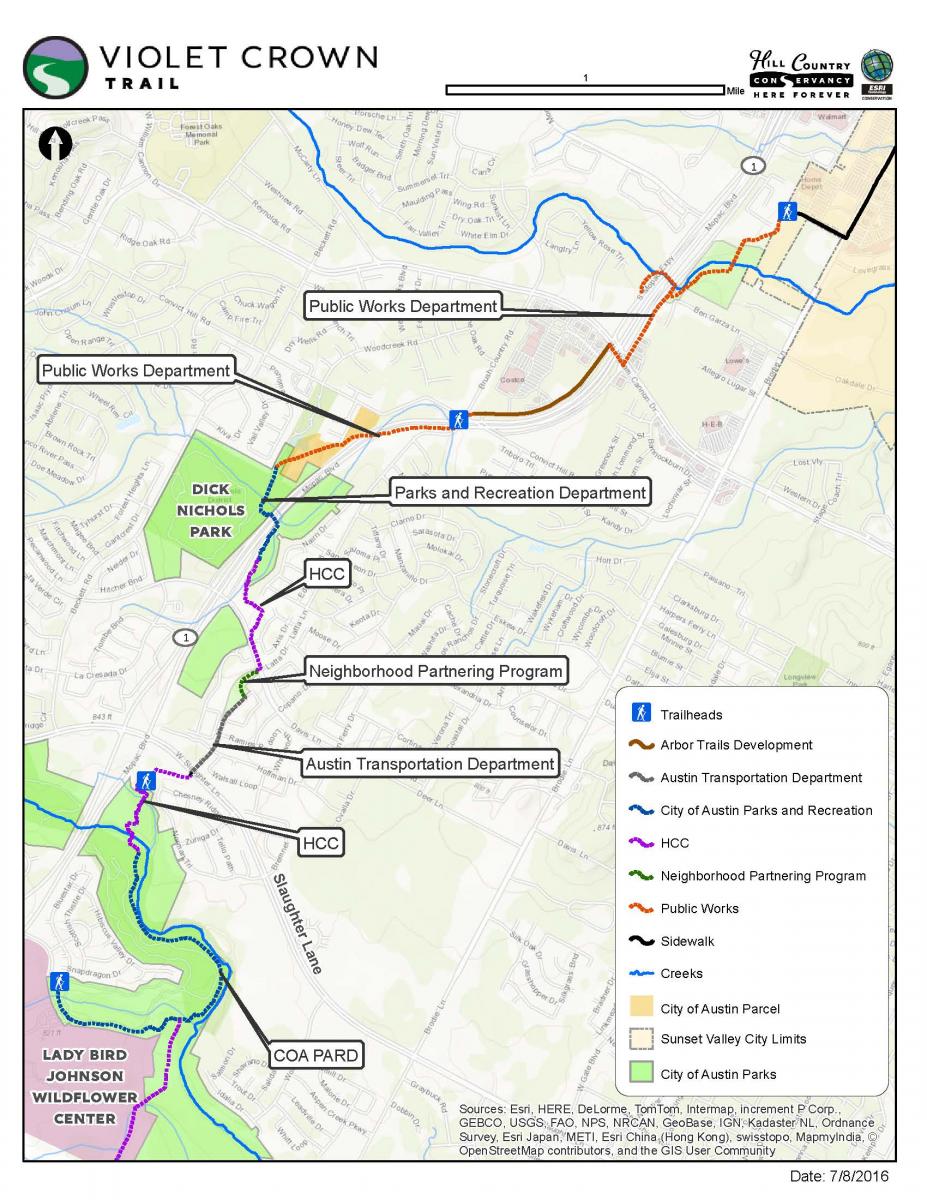

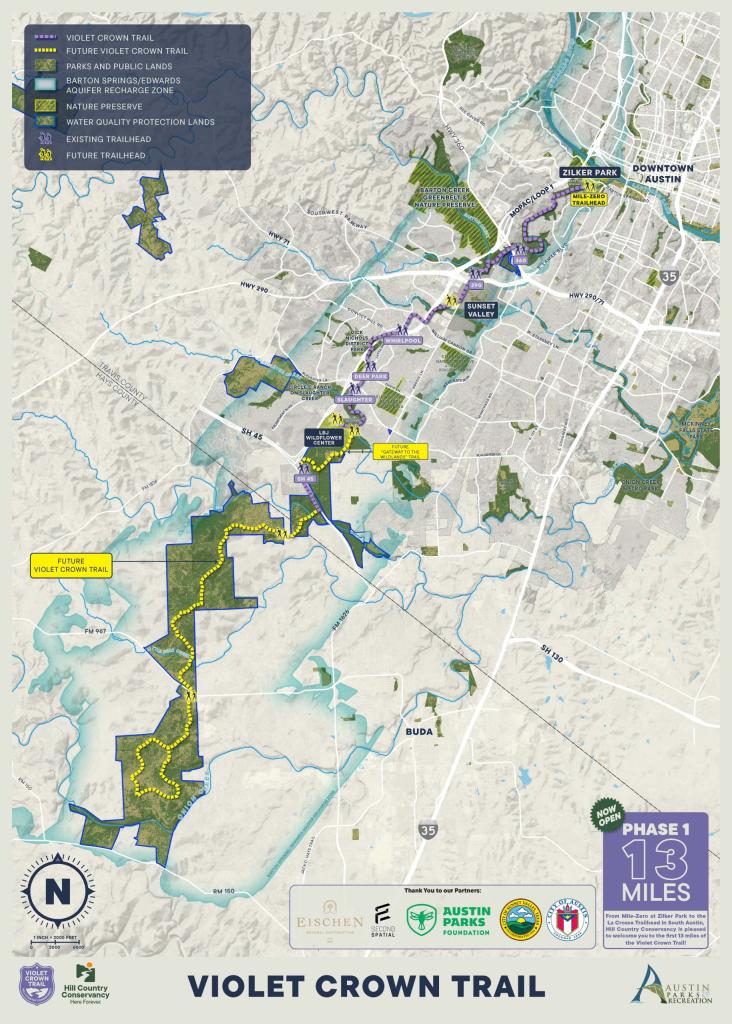

Violet Crown Trail Map

Contact Information

For more information, please contact Parks and Recreation Project Manager, D'Anne Williams by email or by calling (512) 974-9456.
