Walter E. Long Metropolitan Park Improvements

City Council District 1

Project Summary

The Walter E. Long Metropolitan Park Phase 1a improvements will center on the existing Lakeside Park area and emphasize the rehabilitation of the site's infrastructure. The Community Engagement and Design Development phases of the project were completed in early summer 2025. This project is in the permitting phase.

Background

The expansion of the City of Austin’s steam turbine plant along Decker Road in the mid-1960s required a constant source of water for cooling and resulted in the need and development of a new lake in the area. Construction of the dam started in May 1966 and the introduction of water began in early 1967.

Since 1968, the following Land Use Plan items have been implemented and constructed:

  • Two Nature Preserves: Louis Rene Barrera Indiangrass Wildlife Sanctuary and the Decker Tallgrass Prairie Preserve;
  • two boat docks;
  • restrooms (no longer in operation);
  • a portion of a hike and bike trail; and
  • enhanced native grassland areas, main park road, picnic areas, and a swimming area.

In January 2018, Austin Parks and Recreation began a new vision planning process (formerly called master planning). Austin City Council adopted the Walter E. Long Vision Plan on October 15, 2020. The Vision Plan recommends long-term improvements to the metropolitan park, and a suggested framework for Phase 1 implementation.

View the Plan



Project Description

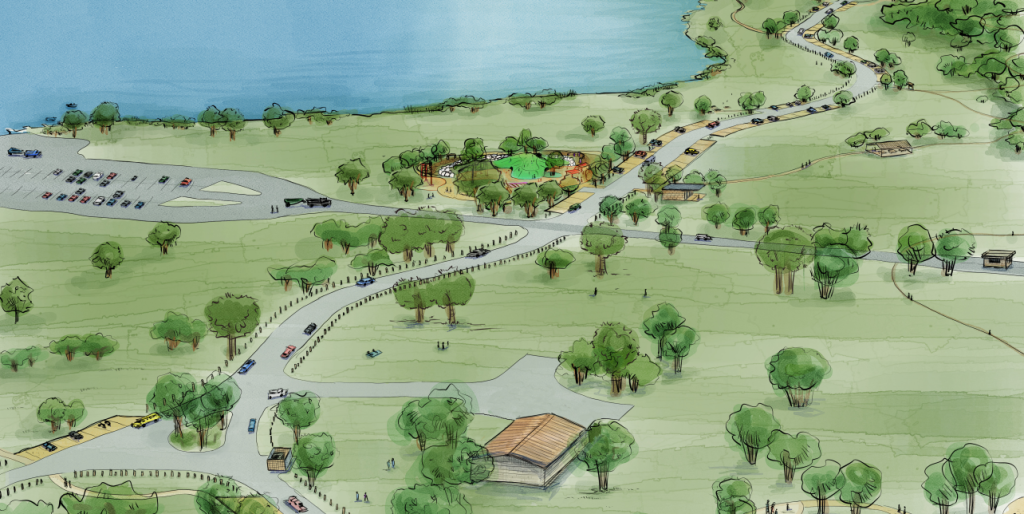

The proposed park improvements for Phase 1a will upgrade the park with roadway and parking improvements, full restroom renovation, a new playground, ADA-accessible picnic areas, nature trails, and significant utility and stormwater improvements. Adjustments to road layouts and other amenities will be made based on their alignment with the vision plan.

Anticipated Schedule: Phase 1a

  • Fall 2022: Scope Development (Complete)
  • Winter 2022: Approved Consultant Project Scope (Complete)
  • Spring 2023: Project Kick-Off (Complete)
  • Fall 2023: Community Meeting and Schematic Design (Complete)
  • Fall 2024: Community Engagement Round 1 (Complete)
  • Winter 2024: Community Engagement Round 2 and Design Development (Complete)
  • Summer 2025: Construction Documents and Permitting (In Progress)
  • Fall 2026: Bidding and Contract Award
  • Spring 2027: Construction Begins

Please note that as in any construction project, schedules are projected as accurately as possible. All dates are subject to change due to the nature of construction and the weather.

Communication and Community Engagement

Community Engagement for Phase 1a took place between 2023 and 2025, and is documented below.

Meetings, Surveys, and Outreach

    DateEventLocationMaterials
    November 15, 2023Community MeetingVirtual

    Meeting Presentation (PDF, 18 MB)

    View Recording

    Ver grabación

    DateEventLocationMaterials
    October 25 to November 17, 2024Community Survey 1Online

    English Survey

    Español encuesta

    Survey Results

    October 25, 2024Pop Up Event 1Overton Elementary Roots and Wings Festival
    October 30, 2024Pop Up Event 2Turner Roberts Recreation Center
    November 7, 2024Pop Up Event 3University Hills Branch Library
    November 9, 2024Pop Up Event 4Violet Crown Ribbon Cutting Ceremony at the Veloway
    November 15, 2024Pop Up Event 5Perez Elementary Fall Festival
    DateEventLocationMaterials
    February 18 to March 30, 2025Community Survey 2Online

    English

    Espanol

    Survey Results

    February 18, 2025Community MeetingVirtual

    Meeting recording

    Meeting presentation (PDF 16.6MB)

    February 20, 2025Pop Up Event 1Austin Capital Delivery Services Informational Session, Turner Roberts Recreation Center
    March 12, 2025Pop Up Event 2Turner Robert Recreation Center
    March 15, 2025Pop Up Event 3Community Engagement Picnic in the Park, Dittmar Recreation Center
    March 20, 2025Pop Up Event 4Austin Parks Foundation Presents Movies in the Park, Gus Garcia District Park

    Funding and Resources

    Funding for Phase 1a was provided by the 2018 GO Bond, Parkland Dedication, mitigation fees, park entry fees, and a grant from the Texas Parks and Wildlife Department.

    Contact Information

    For more information, please contact Reynaldo Hernandez by email or by phone at 512-974-9464.
