Austin Parks and Recreation

Person walking a dog on a paved trail by a river lined with trees

Zilker Metropolitan Park Vision Plan

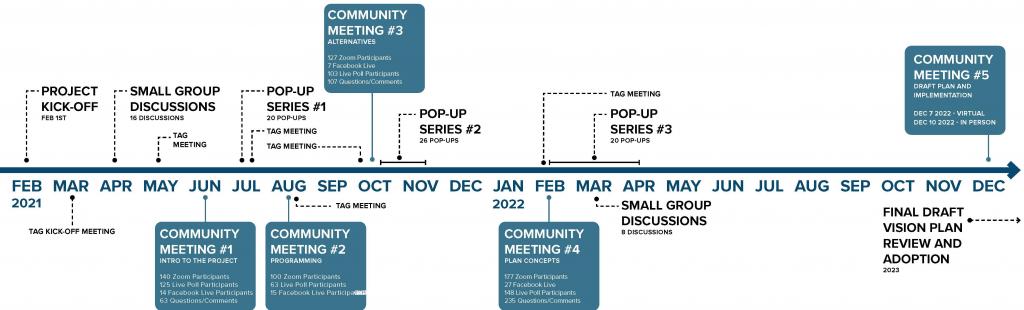

The Zilker Metropolitan Park Vision Plan process was suspended prior to the final Austin City Council presentations. The draft plan and related community engagement can be found on this webpage.

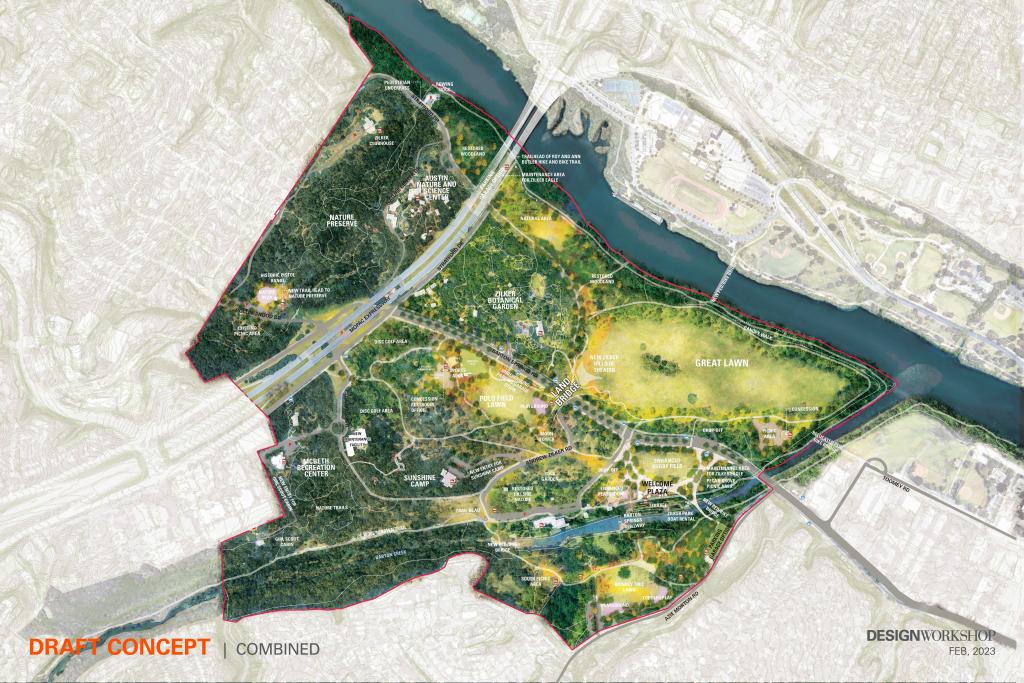

Draft Vision Plan

Last Update

The Zilker Vision Plan was reviewed and recommended with conditions by six Boards and Commissions prior to being placed on the August 2023 Council Agenda. On August 7, 2023, interim City Manager Jesús Garza directed Austin Parks and Recreation (APR) to halt work on the Zilker Park Vision Plan. The decision was announced following a joint statement issued by Council Members Mayor Pro Tem Paige Ellis (District 8), Ryan Alter (District 5) and Zo Qadri (District 9) stating they could not support the plan. Mayor Watson also issued a statement in support of suspending the plan. In response, APR placed the plan on immediate hold, removing the presentation to City Council scheduled for August 29 and 31, 2023.

We appreciate all of the community feedback we received over the years and hope together we can determine a path forward that preserves and protects Zilker Park, ensures equitable access for all who visit, and is embraced by our broader community.

Background

Zilker Metropolitan Park, located 2100 Barton Springs Road, is Austin’s oldest metropolitan park and is named after Andrew Jackson Zilker who donated parcels of land to the city starting in 1917. The park is located at the juncture of Barton Creek and Lady Bird Lake and comprises more than 350 acres of publicly owned land. A major era of park development took place in the 1930s through New Deal programs such as the Civil Works Administration and Civilian Conservation Corps. In 1997, Zilker Metropolitan Park was added to the National Register of Historic Places as the park includes many resources of historical, architectural, and archeological significance.

Today, the park serves as a hub for many recreational activities and includes major facilities and amenities including Barton Springs Pool, Zilker Botanical Garden, Austin Nature and Science Center, Zilker Clubhouse, Girl Scout Lodge, Sunshine Camp, Zilker Hillside Theater, Zilker Caretaker Lodge, Umlauf Sculpture Gardens, McBeth Recreation Center, the Ann and Roy Butler Hike and Bike Trail, and Barton Creek Trail. The park is home to large-scale events such as the Austin City Limits Music Festival, the Trail of Lights, and ABC Kite Festival.

Project Description

The primary goal of this planning project was to develop a visionary framework to guide the restoration and future development of Zilker Metropolitan Park and its numerous facilities and features through a robust public engagement process. The planning process aimed to assess all aspects of the site with a comprehensive lens including but not limited to: programming, maintenance, environmental features and ecology, historical preservation and cultural resources, transportation, circulation, and parking, as well as business operations and management. The goal of the vision plan was to be used as a roadmap for the park’s future by providing recommendations and implementation strategies that facilitate execution of phased improvements and development, and help garner support and funding for future phases through public and private partnerships, operational strategies, revenue generation, and financial sustainability.

Supporting Documents

Community Engagement

As a regional park that draws people from all over the Austin area and beyond, the community engagement process aimed to connect with community members throughout Austin and visitors to the park. The engagement process focused efforts throughout the 10 City Council Districts of Austin, relying on digital engagement to ensure safety during the pandemic but also providing in-person opportunities in accordance with Austin Public Health guidelines. Community engagement began in November 2020 with the initial community survey. You can explore the community engagement plan here (PDF). In addition, Austin Parks and Recreation shared its methodology for reviewing and incorporating community input into the planning process: Memorandum to PARB (PDF), December 22, 2022.

The Community Engagement period ended on January 9, 2023. You can review information from all of the community engagement opportunities throughout the process below.

Previous Engagement

Community Meetings and Surveys

Zilker Community Survey #1: View Survey Results (Survey closed June 4, 2021)

Zilker Park Vision Plan Community Meeting #1
Tuesday, June 29, 2021, 6 p.m. (131 attendees)

Community Survey #2 with Responses from Meeting: View Results (PDF, 14 MB)

Zilker Park Vision Plan Community Meeting #2
Tuesday, August 10, 2021, 6 p.m. (138 attendees)

Community Survey #3 (closed October 4, 2021): Summary (PDF) | Full Results (PDF, 32 MB)

Community Meeting #3: Design Alternatives
Tuesday, October 19, 2021, 6 p.m. (127 attendees)

Community Survey #4 (closed January 10, 2022): View Results

Community Meeting #4: Plan Concepts
February 15, 2022, 6 to 7:30 p.m.
RecordingPresentation (PDF, 28 MB) | Meeting Q&A (PDF) | Grabacion de junta

Community Survey #5 (closed April 11, 2022): View Results

Community Meeting #5

Virtual Meeting
Wednesday, December 7, 6 p.m.

Community Survey #6: Draft Vision Plan Feedback

In-Person Open House
Saturday, December 10, 2022 10 a.m. to 2 p.m.
McBeth Recreation Center
2401 Columbus Dr., Austin, TX 78746

Full Data Sets from Previous Meetings and Surveys

The information provided below contains the full data sets with personally identifiable information redacted. Each file can be downloaded in .csv format.

Pop-up Series 1: June 30 through August 8, 2021

As a metropolitan park that serves the entire city and region, it is important to make sure all parts of the city are informed about and can connect to the Zilker Park Vision Plan. These Pop-ups are a way that the project team can go to all 10 City Council Districts of Austin as well as Zilker Park and meet community members where they are. Each pop-up allowed community members to connect with project team members to get additional information and ask in-depth questions. The following pop-ups were scheduled as part of Pop-Up Series #1:

  • District 1: Givens Park: Saturday, July 3, 10 a.m. to 1 p.m.
  • District 2: Dittmar Pool: Sunday, July 18, noon to 3 p.m.
  • District 3:Govalle Pool: Saturday, July 17, noon to 3 p.m.
  • District 4: Bartholomew Pool: Sunday, July 11, noon to 3 p.m.
  • District 5: Garrison Pool: Saturday, July 10, noon to 3 p.m.
  • District 6: Northwest Family YMCA: Monday, July 19, 7 to 10 a.m.
  • District 7: Balcones Neighborhood Pool: Sunday, July 25, noon to 3 p.m.
  • District 8: Southwest Family Y: Monday, July 26, 7 to 10 a.m.
  • District 9: Shipe Neighborhood Pool: Saturday, July 24, noon to 3 p.m.
  • District 10: Ramsey Neighborhood Park (D10): Saturday, July 31, 10 a.m. to 1 p.m
  • Zilker Park: Barton Springs Pool: Friday, July 16, 4 to 7 p.m.

In addition, Austin Parks and Recreation hosted several other opportunities by connecting to community members at additional events. These pop-ups included:

DateDistrictLocationDate
7/27/2021

8

Zilker Park Great Lawn7/27/2021
7/27/2021

3

Pan American Park7/27/2021
7/28/2021

8

Zilker Park Great Lawn7/28/2021
8/1/2021

8

Circle C Ranch Metropolitan Park8/1/2021
8/6/2021

1

Mt. Zion Baptist Church8/6/2021
8/7/2021

7

Beverly S. Sheffield Northwest District Park8/7/2021
8/7/2021

3

Oak Springs School Park8/7/2021
8/8/2021

9

Republic Square8/8/2021
Zilker Park Community Ambassadors: July through September 2021

From July through September 2021, two Austin Parks and Recreation Community Ambassadors were selected to partner with community members to prioritize the advancement of racial equity in Zilker Park planning. The Ambassadors were trained in community engagement practices, history of Austin, and organizing and engaging community around the Zilker Park Vision Plan.

Ambassadors were tasked with meaningfully engaging with the following special stakeholders:

  • Black, Indigenous, people of color
  • Youth
  • LGBTQIA+ communities
  • Immigrant, migrant, and/or refugee communities
  • Union workers
  • People with disabilities
  • Low-income communities
  • People experiencing homelessness

Each Ambassador met with at least 10 community members to have significant conversations around the following themes:

  • Do you go to Zilker? Why or why not?
  • What events or programming would draw you to Zilker?
  • How do we plan for a future Zilker Park that is more inclusive for people who have been traditionally left out?

View the combined final reports here (PDF).

Pop-Up Series 2: August 10 through October 4, 2021

Following Community Meeting #2, Austin Parks and Recreation continued to reach out to community members to promote the Zilker Park Vision Plan and Community Survey #3, especially to underrepresented community members. Additional outreach and pop-ups included the following:

DateDistrictLocation
8/16/2021

7

Walnut Creek Metropolitan Park
8/23/2021

8

Zilker Park
8/24/2021

4

Chinatown Center
8/24/2021

1

East Communities YMCA
8/25/2021

9

UT Austin
8/26/2021

4

North Lamar, Silkcut China town
8/26/2021

9

ESB-MACC
8/26/2021

1

Heritage Pointe Apartments
8/26/2021

1

Eastside Early College Prep High School
8/27/2021

1

Carver Museum and Cultural Center
8/30/2021

3

Roy G. Guerrero Metropolitan Park
8/31/2021

4

Gus Garcia Recreation Center
9/1/2021

8

Zilker Park
9/2/2021

7

Walnut Creek Metropolitan Park
9/3/2021

8

Zilker Park
9/4/2021

9

Hoover's Restaurant on Manor Road
9/7/2021

1

Copperfield Neighborhood Park
9/8/2021

8

Zilker Park
9/8/2021

1

East Communities YMCA
9/8/2021

1

St. James Baptist Church
9/8/2021

1

Greater Mount Zion Baptist Church
9/7/2021

1

Givens District Park
9/8/2021

2

Dittmar Recreation Center
9/8/2021

1

Givens District Park
9/9/2021

2

Dove Springs Recreation Center
9/10/2021

1

Austin Urban League Office
9/10/2021

3

Montopolis Recreation Center
9/10/2021

1

Palomino Coffee
9/18/2021

1

AARC
9/21/2021

8

UT Austin
9/24/2021

8

Austin Zoo
9/25/2021

6

Springwoods Neighborhood Park
9/25/2021

3

Civitan Neighborhood Park
9/29/2021

3

Fiesta Gardens Degollado Pavilion
Pop-up Series 3: October 25, 2021 through January 9, 2022

As a metropolitan park that serves the entire city and region, it is important to make sure all parts of the city are informed about and can connect to the Zilker Park Vision Plan. The second round of Pop-ups continued to reach out to all 10 City Council Districts of Austin as well as Zilker Park and meet community members where they are. Each pop-up allowed community members to connect with project team members to get additional information and ask in-depth questions. The following pop-ups were scheduled as part of Pop-Up Series #2:

  • Zilker Park: Outside Barton Springs Pool north entrance, near Zilker Cafe: Monday, October 25, 4 p.m.
  • District 1: Austin Country Flea Market: Sunday, November 14, 10 a.m.
  • District 2: Dove Springs Recreation Center: Tuesday, October 26, 5 p.m.
  • District 3: South Austin Recreation Center: Friday, November 19, 5 p.m.
  • District 4: COA/North Austin YMCA: Saturday, October 30, 10 a.m.
  • District 5: Manchaca Road Branch, Austin Public Library: Saturday, November 13, Noon
  • District 6: H Mart: Sunday, November 7, Noon
  • District 7: North Village Branch, Austin Public Library: Friday, November 5, 3 p.m.
  • District 8: Circle C Ranch Metropolitan Park: Saturday, November 13, 9 a.m.
  • District 9: Emma S. Barrientos Mexican American Cultural Center: Monday, November 1, 5 p.m.
  • District 10: Old Quarry Branch, Austin Public Library: Monday, November 15, 3 p.m.
  • Zilker Park: Zilker Holiday Tree: Sunday, November 28, 6 p.m.

In addition, Austin Parks and Recreation continues to provide other opportunities by connecting to community members at additional events. The following additional in-person outreach and pop-ups took place:

DateDistrictLocationEvent
11/17/2021

4

Gus Garcia Recreation CenterEMS Resource Fair
11/17/2021

1

Turner-Roberts Recreation CenterOpen House Meeting
11/18/2021

1

Turner-Roberts Recreation CenterOpen House Meeting
11/20/2021

1

Eastlink Trail: Boggy Creek TrailPillars on Eastlink Trail
12/4/2021

3

Krieg FieldLGBTQIA+ Resource Fair
12/10/2021

3

Fiesta Gardens Degollado PavilionPARD Staff Luncheon
12/12/2021

9

Republic SquareHoliday Market with Downtown Alliance & Frida Friday
12/14/2021

9

Meadowbrook Apartments (HACA)Residents Council Meeting
12/14/2021

3

Bouldin Oaks (HACA)Residents Council Meeting
12/15/2021

9

ESB-MACCBallet Folklorico Posada
12/15/2021

1

AARCAARC Symphony
12/16/2021

7

Northwest Recreation CenterTeen Afterschool Program
12/18/2021

3

Pan-American "A.B. Cantu" Recreation CenterHoliday Drive-Through
12/29/2021

8

Zilker Park Playscape and Hike-and-Bike Trail
12/29/2021

1

George Washington Carver Museum and Cultural CenterKwanzaa Celebration and Ujima Marketplace
Pop-up Series 4: February 17 to April 9, 2022

This series of pop-ups, sharing the 3 plan concepts for the Zilker Park Vision Plan, took place between March 11 and April 9, 2022. The locations included sites in City Council District 1 (Givens Recreation Center, Asian American Resource Center), District 2 (Dittmar Recreation Center), District 3 (Mendez Recreation Center, Montopolis Recreation and Community Center), District 4 (Gus Garcia Recreation Center), and Zilker Park (Kite Fest and event honoring Joan Means Khabele at Barton Springs Pool). View the comments posted on the boards here (PDF). Also, view the tallies of dots posted next to preferred amenities here (PDF).

Boards were posted at the following locations for community members to post dots on preferred amenities:

  • Montopolis Recreation and Community Center (District 3): March 11 to 31, 2022
  • Mendez Recreation Center (District 3): March 11 to 16, 2022
  • Dittmar Recreation Center (District 2): March 11 to 16, 2022
  • Givens Recreation Center (District 1): March 16 to 30, 2022
  • Gus Garcia Recreation Center (District 4): March 16 to 21, 2022

Pop-ups with Austin Parks and Recreation staff occurred at the following dates and locations:

Name of EngagementDistrict

Date

Number of participants

Zilker outreach

Zilker

2/17/2022

40

Carver Museum Black History Month Block Party

1

2/19/2022

50

Housing Authority for the City of Austin (Public Housing) City Wide meeting with Staff



3/8/2022

24

Elisabet Ney Nature Day Museum

9

3/12/2022

25

Mendez Recreation Center

3

3/14/2022

20

Bartholomew District Park

4

3/16/2022

6

Mueller Park

9

3/16/2022

10

Give a Bark About Your Park (hosted by UT Student Services) and Great Lawn outreach

Zilker

3/16/2022

40

Gus Garcia Recreation Center

4

3/18/2022

10

Zilker Park Vision Plan outreach at Bartholomew Park and Mueller Lake Park (informal pop-up/outreach)

4, 9

3/18/2022

25

Carver Museum Book Club

1

3/18/2022

6

Montopolis Recreation Center

3

3/21/2022

5

Dittmar Recreation Center

2

3/22/2022

7

Gus Garcia Recreation Center

4

3/23/2022

10

Goodrich Resident Council Meeting

5

3/24/2022

10

South Properties (HACA)

3, 5

3/24/2022

7

Carver Museum Vendor Fair and Carver Genealogy Center

1

3/26/2022

20

Asian American Resource Center

1

3/29/2022

45

ABC Kite Fest

Zilker

4/3/2022

150

IMOM Program the Women of HACA (Santa Maria Village Apartments)

4

4/5/2022

32

Ceremonial Moment of Silence & Splash Honoring Joan Means Khabele (Desegregating Barton Springs Pool)

Zilker

4/9/2022

75

Pop-Up Series 5: November 15, 2022 through January 8, 2023

After the release of the draft Zilker Park Vision Plan on November 15, Austin Parks and Recreation went to all 10 districts to raise awareness and get feedback on the vision plan. Below are the 21 pop-ups that were held:

DistrictPop-UpDate

1

AARC Phase 2 Reveal Community MeetingNovember 17, 2022

1

Carver Museum Voices of EvergreenNovember 29, 2022

1

Equity Action Team MeetingDecember 3, 2022

1

Conley-Guerrero Senior Activity CenterDecember 14, 2022

2

Southeast Branch LibraryDecember 9, 2022

2

Dittmar Recreation CenterDecember 10, 2022

2

Armadillo Neighborhood Park Open HouseDecember 17, 2022

3

Montopolis Recreation and Community CenterDecember 3, 2022

3

South Austin Recreation CenterDecember 9, 2022

3

Willie Mae Kirk Branch LibraryDecember 17, 2022

4

Gus Garcia Recreation CenterNovember 19, 2022

4

COA/North YMCAJanuary 6, 2023

5

South Austin Senior Activity CenterDecember 13, 2022

6

Spicewood Springs Branch LibraryJanuary 7, 2023

7

Balcones District ParkDecember 4, 2022

8

Circle C Metropolitan ParkNovember 26, 2022

8

Oak Hill Hampton Branch LibraryDecember 12, 2022

9

Adams-Hemphill Park Open HouseDecember 3, 2022

10

Old Quarry Branch LibraryDecember 17, 2022

Zilker

Zilker Tree LightingNovember 27, 2022

Zilker

Trail of Lights at Zilker TreeDecember 16, 2023
Small Group Discussions: Round 1

Small Group Discussions are small-scale, focused conversations around particular topics or subjects. After the series of discussions are completed, the meeting recordings were posted below with links to YouTube. If information was provided in the meeting chat, that information has also been provided.

Small Group Discussion presentation (PDF)

  • Austin Parks and Recreation Operations: April 29, 2021, noon (view | chat)
  • Environment-Water Issues: May 3, 2021, noon (view)
  • Events (Large): May 3, 2021, noon (view)
  • Events (Small): May 4, 2021, 5 p.m. (view)
  • Neighbors I: May 5, 2021, 5 p.m. (view)
  • History-Culture-Tourism: May 6, 2021, 5 p.m. (view)
  • Area Businesses and Concessionaires: May 10, 2021, noon (view)
  • Exploring Equity and Inclusion: May 10, 2021, 5 p.m. (view)
  • Parkners and Nonprofits: May 11, 2021, noon (view | chat)
  • Higher Education Partners: May 12, 2021, noon (view)
  • Recreation: May 12, 2021, 5 p.m. (view)
  • K-12 Schools and Youth Partners: May 13, 2021, 11:30 a.m. (view | chat)
  • Circulation-Connectivity-Transportation: May 14, 2021 noon (view | chat)
  • Neighbors II: May 18, 2021, 5 p.m. (view)
  • Exploring Equity and Inclusion 2: May 27, 2021 noon (view | chat)
  • Texas School for the Deaf: June 28, 2021, 3:30 p.m. (view)
Parks and Recreation Board Presentations and PARB Zilker Park Vision Plan Working Group

A working group was established by the Parks and Recreation Board. Below are recordings of meetings as they occur.

The Zilker Park Vision Plan team also presented to the Parks and Recreation Board in the following meetings prior to the approval of the Draft Vision Plan.

  • August 24, 2021: Update on the Zilker Metropolitan Park Vision Planning Process: view presentation
  • January 25, 2022: Presentation and discussion on the community engagement and outreach efforts for the Zilker Metropolitan Park Vision Plan (Item postponed): view presentation
  • February 22, 2022:
    • Presentation and discussion related to City of Austin Community Engagement and Surveying Practices: view presentation
    • Presentation and discussion related to the community engagement and outreach efforts for the Zilker Metropolitan Park Vision Plan: view presentation
  • April 25, 2022: Presentation and discussion related to the community engagement and outreach efforts for Zilker metropolitan Park Vision Plan: view presentation
  • January 23, 2023: Discussion and possible action on the draft Zilker Park Vision Plan public engagement process (Board item, staff not invited to present)
  • February 27, 2023: Staff Briefing on the draft Zilker Park Vision Plan: view presentation
Technical Advisory Group

The Technical Advisory Group (TAG) is comprised of City of Austin representatives from various departments who provide technical expertise on different elements and concerns in and around Zilker Metropolitan Park. The members of the TAG ensure their department's goals, policies, plans, and constraints are understood in relation to Zilker and are communicated with the project team. Meetings will be recorded and posted for review by community Members.

View TAG members (PDF, updated July 2021)

  • TAG Meeting #1, March 3, 2021 (view)
  • TAG Meeting #2, May 5, 2021 (view)
  • TAG Meeting #3, July 7, 2021 (view | chat)
  • TAG Meeting #4, August 18, 2021 (view | chat)
  • TAG Meeting #5, October 27, 2021 (view recording)
  • TAG Meeting #6, February 23, 2022 (view | chat)
  • TAG Meeting #7, October 18, 2022 (view)
Additional Meetings and Information with Special Interest Groups

In addition to the meetings above, the following meetings have been recorded and posted.

  • Meeting with Zilker Park partners, January 14, 2022 (view | chat)
  • Meeting with leaders of neighborhood associations near Zilker, February 11, 2022 (view | chat)
  • Meeting with Zilker Collective, March 24, 2022 (view)
  • Meeting with Black Women Who Kayak, March 30, 2022 (view)
  • Meeting with Boys and Girls Club of Austin, April 14, 2022
  • Meeting with RISE School, May 2, 2022 (view)
  • Eco Uplift Small Group Discussion 1, June 29, 2022 (view)
  • Eco Uplift Small Group Discussion 2, June 30, 2022 (view)
  • Meeting with Zilker Collective, November 28, 2022 (view)
  • Meeting with Zilker Collective Impact Working Group, January 4, 2023 (view | chat)

Meetings with Rewild Zilker Representatives

The planning team has been committed to connecting to all key stakeholders and experts throughout the process. The Rewild Zilker group is sponsored by SOS Alliance and Zilker Neighborhood Association (ZNA) with members from Bouldin Creek N.A., Barton Hills N.A., Sierra Club, Austin Master Naturalists, Safe Bike Austin (several members wearing multiple hats). The Rewild Zilker group and its members have had significant influence on the plan and have been involved throughout the process. The planning team has met with representatives of this group or its members more than any other group, including the meetings with Austin Parks and Recreation (APR) and other organizations listed below:

ZPVP Meetings with Rewild Zilker representatives:

  • May 3, 2021: Small Group Discussion Round 1 "Environment-Water Issues" included representative from SOS/ZNA/Rewild; Note: several organizations invited, few attended.
  • May 18, 2021: Small Group Discussion Round 1 "Neighbors II" included representatives from ZNA, Barton Hills N.A., Bouldin Creek N.A.; Note: several adjacent neighborhood organizations invited, one other attended (City of Rollingwood)
  • May 21, 2021: Coffee meeting included representatives from SOS, Rewild, ZNA, Kurt Culbertson and Claire Hempel (Design Workshop)
  • November 16, 2021: Zilker Vision Plan and Rewilding Report Discussion included representatives from ZNA/Rewild Zilker, Ana Gonzales and Ingrid Karklins (Austin Watershed Protection), Amanda Ross and Greg Montes (APR)
  • February 11, 2022: Meeting with leaders of neighborhood associations near Zilker included representatives from ZNA, Sierra Club, Rewild Zilker, Barton Hills N.A., SOS Alliance
  • December 20, 2022: Rewild Zilker Meeting with representatives from ZNA, SOS, Design Workshop, Siglo, and APR
  • January 9, 2023: Zilker Site Visit with representative from ZNA, Rewild Zilker SOS Alliance, and Jonathan Ogren (Siglo)
  • May 31, 2023: Meeting with SOS Alliance representative Bobby Levinski and Sierra Club representative Roy Whaley with APR Director Kimberly McNeeley to discuss primary concerns of draft plan.
  • September 27, 2023: Rewild representatives Robin Rather, Tanya Payne, Ana Aguirre and Mark May met with APR Director Kimberly McNeeley and APR staff members Ricardo Soliz and Justin Schneider. Also present were APR guests Heidi Anderson of the Trail Conservancy, Councilmember Ryan Alter and his staff Ben Leffler along with PARB Chair, Pedro Villalobos. (notes, PDF)

These groups were also represented at each community meeting and were able to provide input during those events. Additional emails have also been exchanged throughout the process.

Meetings with C3 Presents (ACL Music Festival organization)

As an existing stakeholder in the park, the planning team has met with C3 Presents and other organizations with events in Zilker, primarily for information gathering, understanding the footprint they use and how park management occurs during the events, including external and internal shuttles. The planning team has not attempted to hide any of these meetings, and they are now added on the webpage. The meetings are listed below.

  • May 3, 2021: Small Group Discussion "Large Events" included representatives from C3 Presents, Trail of Lights Foundation (TOL) and Kite Festival Foundation; Note: Zilker Relays and Blues on the Green representatives invited and did not attend.
  • January 7, 2022: Events meeting with C3 Presents, TOL, Kite Festival
  • February 7, 2022: Events follow-up with C3 Presents, TOL, Kite Festival
  • March 7, 2022: C3 Presents with PARD Special Events Office
  • September 15, 2022: C3 Presents at their office

Meetings focused on Equity and Inclusion

  • Equity and Inclusion at Zilker, March 1, 2022 (notes, PDF)
  • Interpreting the Park through an Equity Lens, March 23, 2022 (view)

Interviews about Zilker Park Vision Plan

  • KAZI Interview, March 23, 2022
  • Austin Parks Foundation Podcast
    • Part 1, December 14, 2021
    • Part 2, April 8, 2022 (listen)
Public Information Requests and Responses

As of October 19, 2023, Austin Parks and Recreation (APR) has received the following public information requests connected directly to the Zilker Park Vision Plan process.

PIR NumberDateTopicResponse (PDF)
C130959April 2022Impervious CoverResponse
C149388September 2022ATD TxDoT CTRMA MeetingResponse
C167550February 2023Electronic Copies of Geographic Locations: Some files requested were considered under "trade secret" exceptions. Design Workshop offered to release these files if Waiver was signed. Requestor refused to sign waiver. Attorney General ruling is also attached.

GIS Files (ZIP)

Park Info & Maps (ZIP)

Design Workshop Waiver
Attorney General Ruling

C171327March 2023Draft Vision Plan CriteriaResponse
C175156March 2023Correspondence with Office of SustainabilityResponse
C178534April 2023Electronic Copies of ContractsResponse
C186926July 2023Analyses, Calculations, Referenced DocumentsResponse
C188426July 2023Attendees, Notes, Emails, Recordings of meetings with C3 PresentsResponse
C192329August 2023Carbon Sequestration DataResponse
C192381August 2023Benefits and Cost RelationResponse
C195761September 2023Dimensions of Parking GarageResponse
C195765September 2023Lou Neff RoadResponse
C203635November 2023Documents that mention traffic, parking studyResponse
C204722December 2023Information about funding and total cost for vision planResponse
C206132December 2023Request for copy of Nelson Nygaard ReportResponse

All responses listed above have been completed with responses sent to requestor.

Internal Audit of Zilker Park Vision Plan Survey #6

A request for an audit connected to the final survey process of the Zilker Park Vision Plan was referred to the Austin Parks and Recreation director by the City Auditor's Integrity Unit. An Austin Public Health Internal Auditor was assigned to review the allegations as an independent reviewer. The full report was completed in March 2024.

Boards and Commissions

Parks and Recreation Board

Pedestrian Advisory Council and Bicycle Advisory Council: Joint meeting, March 6, 2023 (view presentation, PDF, 27 MB | recommendation, PDF)

Urban Transportation Commission: April 4, 2023 (view presentation, PDF, 19 MB | recommendation, PDF)

Environmental Commission: April 5, 2023 (view presentation, PDF, 21 MB | recommendation, PDF)

Design Commission: April 13, 2023 (view presentation, PDF, 19 MB | recommendation, PDF)

Mobility Committee (Committee of City Council): May 11, 2023 (view presentation, PDF, 11 MB)

Plan Concepts

Below are the 3 Plan Concepts that community input was gathered on to create the draft Vision Plan. You can still review each concept. Click on the image of concept to view a PDF of the concept. To view a PDF with each concept, view the Comparisons PDF here (22 MB).

Stitch, Edges, Regenerate

Concept A: Stitch
ZPVP Concepts A stitch image 2022-02-15
Concept B: Edges
ZPVP Concepts B edges image 2022-02-15
Concept C: Regenerate
ZPVP Concepts C regenerate image 2022-02-15

Funding and Resources

Funding for this planning process is a result of the 2012 General Obligation Bond that was approved by City of Austin voters in November 2012.

Consultant Team

The Design Workshop, Inc. was selected as the prime consultant for the Zilker Park Vision Plan.

Contact Information

For more information, email the Zilker Vision project team or call (512) 974-9458.

Zilker-Gate-11-19-2020
